Up

Customer Success Story

Complex ERP Implementation in 11 Months—Thanks to a Proven Methodology

A custom manufacturer with its own software development team implemented a new ERP system in 11 months: the project began in January 2025, and Microsoft Dynamics 365 Finance & Supply Chain Management went live on January 1, 2026. The project was supported by ICB GmbH with a team of 6 to 8 consultants.

Company
Custom manufacturer with in-house software development
Production Type
Custom Manufacturing of Complex Systems
Project Team
6 to 8 consultants, one expert per end-to-end process
Time period
January 2025 through Go-Live January 1, 2026 · 11 months
Target System
Microsoft Dynamics 365 Finance & Supply Chain Management
Engineer working on a custom-built testing system with an aluminum frame, actuator, and control cabinet in a laboratory

A custom manufacturer with two business models under one roof

The customer combines two business models under one roof: software development—that is, research and development as a separate process—and a manufacturing business in which complex technical systems are built to customer specifications. Each of these systems is one-of-a-kind, making this a classic example of custom manufacturing. Both business models had to be integrated into a single system. The system was first implemented at the main location in Germany, with other locations to follow later.

A warehouse worker with a clipboard checks inventory on the shelves by visual inspection, without system support

Inventory counts based on visual inspection rather than the system: the situation that the project resolved. Image: AI-generated.

What happens when an ERP system is implemented but not used?

An ERP system was already in place, but its implementation had effectively failed. The processes had not been set up properly or thought through from start to finish, and the data structures had not been properly migrated. As a result, there was no robust foundation for processes and data. The consequence: The system was used only in a rudimentary way. Warehousing, logistics, and production largely operated independently of it. Inventory was assessed by visual inspection rather than through the system, and material requests were made verbally or by phone. The ERP system was used primarily to retroactively record events that had long since taken place. This is a pattern we recognize from our projects: It is not the technology that fails, but the process and data work that precedes it. Therefore, a simple fix was not an option; instead, a fresh start on a new platform was necessary.

The Task: A System for Custom Manufacturing and Development

The decision on the system had already been made at the start of the project; it was the result of a prior ERP selection process. The focus here was on implementation. The scope encompassed the entire ERP core: all end-to-end processes across all departments, including all interfaces and peripheral systems. In addition, there were two integrations: The customer had recently implemented Microsoft Dynamics 365 Sales, and integration between CRM and ERP was required in virtually all processes. An existing service system—not from Microsoft—was integrated without mapping service processes in the ERP. The target date of January 1, 2026, was set from the outset and served as the overarching framework against which the entire approach had to be aligned.

How do you get to go-live in 11 months?

Completing a full ERP core in eleven months is only possible if the methodology and the team are a good fit. We set up the project according to our process model for ERP implementation and deliberately kept the team small: 6 to 8 consultants, with one expert per end-to-end process. The ICB IGNITE methodology is driven by three “conference room pilots”—that is, sessions in which business units and consultants jointly build and run through the processes in the system, rather than describing them on paper. The second key factor was the sequence: All end-to-end processes were first consistently developed using the standard Dynamics 365 Finance & Supply Chain Management configuration and were demonstrated in their entirety. Only then did the business units identify where further customization would add value. Rather than discussing things theoretically, decisions were made based on the live system: This saves time, keeps the team small, and reduces costs.

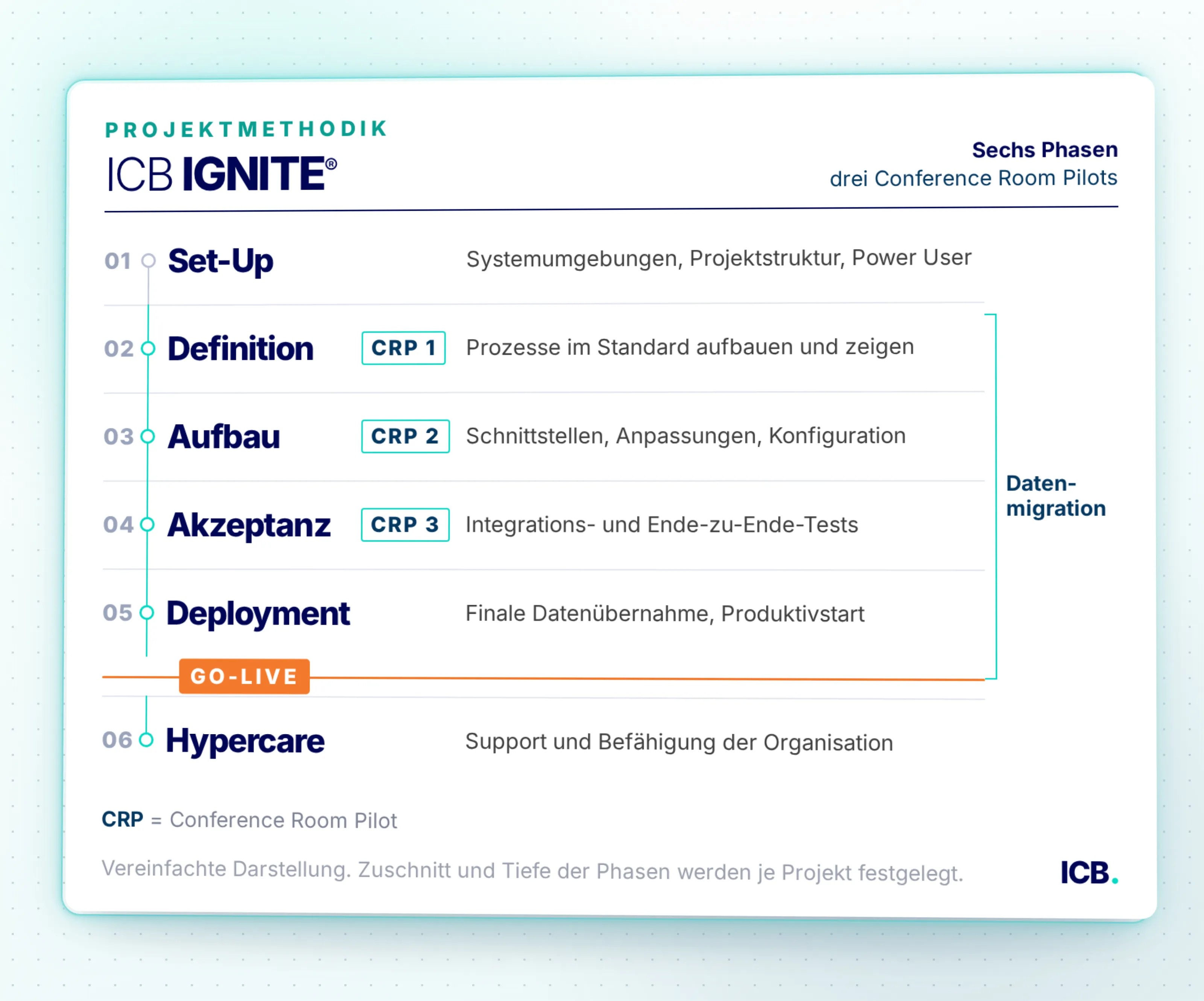

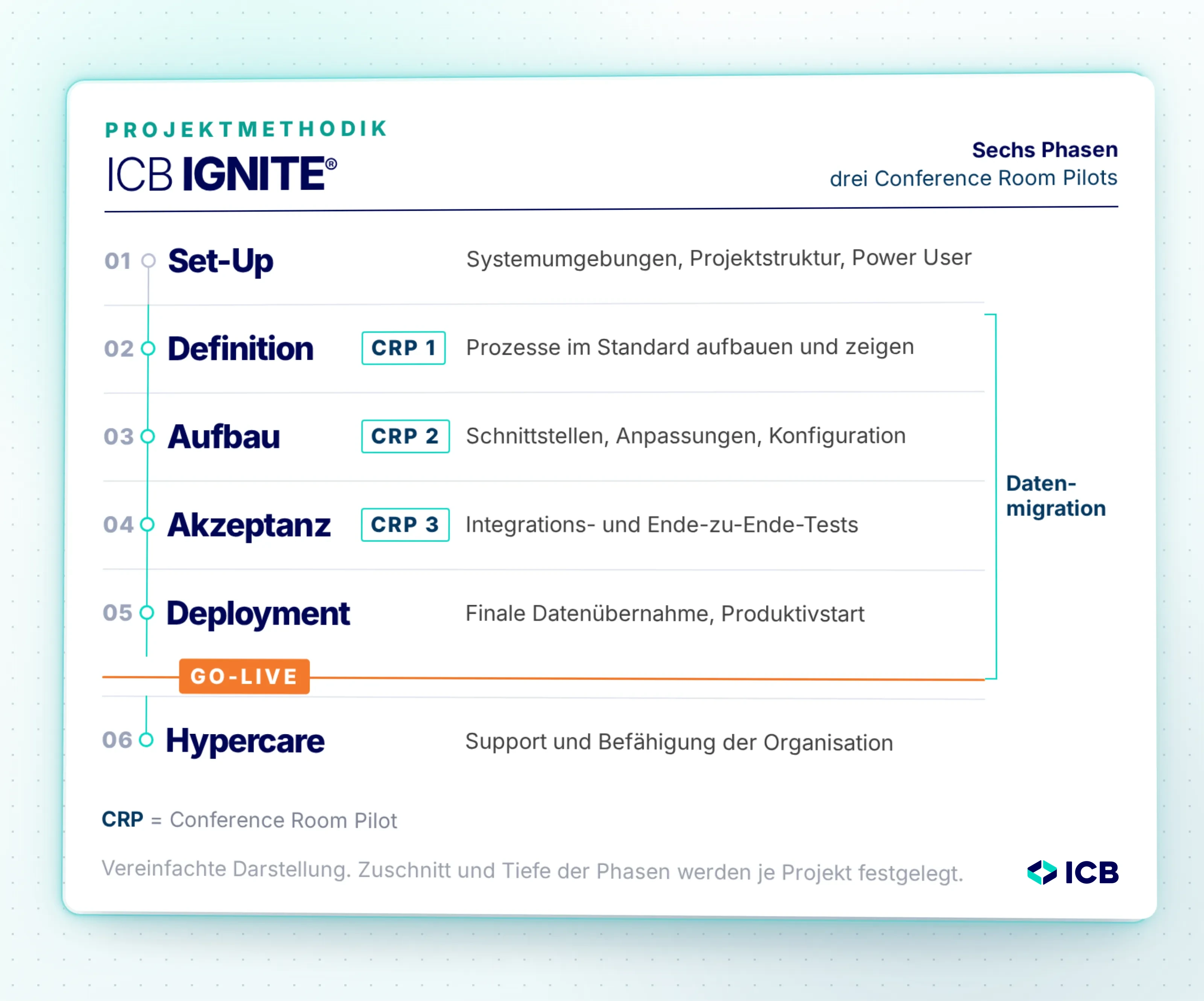

Simplified phase diagram of the ICB IGNITE project methodology, showing the Set-Up, CRP 1, CRP 2, CRP 3, Deployment, and Hypercare phases
Consultants and power users sit together in front of their screens and work in the new ERP system as part of a train-the-trainer workshop

Train-the-Trainer: Power users from the business units work together with the consultants in the system from the outset and later train their own teams. Image: AI-generated.

The biggest hurdle isn't the technology

Based on our project experience, the most difficult challenge in an ERP implementation is rarely the technology itself, but rather change management. Employees are expected to adopt a new platform, new processes, and a new user interface. Some go along with it, some take a wait-and-see approach, and there are critics and naysayers. We hear from many companies that this—and not the software itself—is where the real hurdle lies. This work cannot be outsourced. It must run as a separate, in-house initiative in parallel with the project. We support and empower the power users, who are introduced to the system from the very beginning and then train their own teams. This creates advocates early on. The initiative must come from the client’s side: Those who fill this role early on have one less risk factor to contend with.

The result: a go-live on schedule and a template for the rollout

The go-live took place right on schedule on January 1, 2026, and the final data migration was successful. During the hypercare phase, we resolved the remaining issues and enabled the organization to work with the system to its full extent. The company gained the following from the project:

Go-live on schedule on January 1, 2026, eleven months after the contract was awarded

All end-to-end processes, including interfaces and peripheral systems, are within the scope

Two business models in one system: custom manufacturing and development

Integration with Microsoft Dynamics 365 Sales in virtually all processes

The final data migration for the go-live was successful

Power Users Established as Coaches for Their Own Teams

Structured and documented knowledge about Azure DevOps and ICB IGNITE

The Germany template as the basis for the rollout to other locations

The Added Value for the Company

Deadline met

Go-live on January 1, 2026, eleven months after the contract was awarded—including all end-to-end processes, interfaces, and peripheral systems.

Get up and running faster

The early start to the master data migration and the implementation of the standard system enabled the business units to begin productive work quickly.

Clear Processes and Transparency

Consistent end-to-end processes, resulting in more stable workflows. Knowledge is structured and documented through Azure DevOps and ICB IGNITE.

Template for the Rollout

The Germany template serves as the basis for the rollout. This means that other locations do not need to be designed from scratch.

FREQUENTLY ASKED QUESTIONS

What prospective buyers often want to know.

How long does an ERP implementation with Dynamics 365 Finance & Supply Chain Management take?+
This project spanned eleven months between the contract award in January 2025 and the go-live date on January 1, 2026. The duration depends on the scope: In this case, it included all end-to-end processes of a custom manufacturer, including interfaces and peripheral systems. A key factor in meeting the deadline was that the system selection had already been made before the project began and the processes were first set up using the standard configuration.
What to Do When an ERP Implementation Has Failed?+
A fresh start first requires a robust process and data foundation—which is exactly what was missing in the case described. The existing system was used only in a rudimentary way because processes had not been designed end-to-end and data structures had not been properly migrated. ICB GmbH is therefore rebuilding all end-to-end processes and initiating data migration as a parallel stream early in the project phase.
What does “standard first” mean in an ERP implementation?+
"Standard first" means that all processes are initially set up strictly according to the system standard and presented to the company in their entirety. Only then does the business unit decide where a customization beyond the standard actually adds value. This saves time spent on discussions, keeps the project team small, and reduces costs; in this project, 6 to 8 consultants were sufficient.
What is the biggest challenge when implementing an ERP system?+
In ICB GmbH’s experience, the challenge lies not in the technology but in change management: Employees must embrace a new platform, new processes, and a new user interface, and there will inevitably be critics and those who resist change. This effort must be managed as a separate initiative within the company itself; while a service provider can offer support, the initiative must come from within. A “train-the-trainer” approach is helpful, in which power users are involved early on and then train their own teams.
